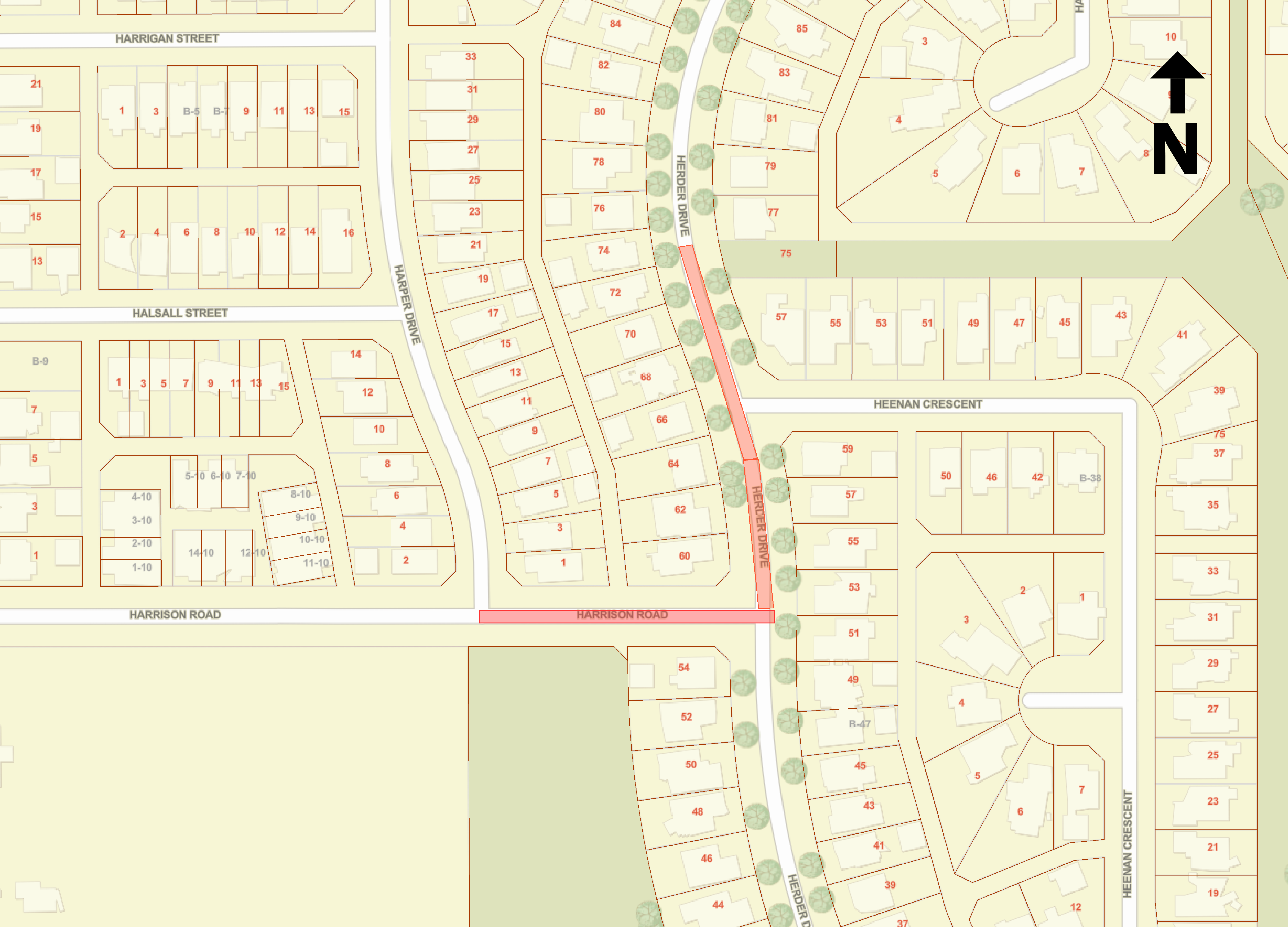

April 01 2025 → November 18 2026

ESTIMATED: Herder Drive Rehabilitation

Planned work for 2025 - 2026 includes:

  • Rehabilitation of Herder Drive from the park trail just north of Heenan Crescent to 47 Avenue
  • Tentatively scheduled to take place within the next 3 years
  • Council and administration have not confirmed when this phase of construction will take placeThis work is included in our 10-year capital plan. Before we can schedule the work, we must first investigate the site. Then we can create a design for the construction. We work backwards from there to figure out dates
  • Spring 2025: The second layer of asphalt, more concrete repairs, and landscaping from Hagerman Rd to the park trail just north of Heenan Crescent


Why can't we do construction projects according to a set schedule?

  • Weather is the boss of construction. If we have bad weather, we must delay projects

  • Construction supplies sometimes arrive on time, sometimes they arrive late. For example, if concrete supplies for sidewalks are delivered late, we can't start the construction

  • Sometimes we find surprises in the ground. We make every effort to survey before breaking ground, but sometimes we find underground utilities like gas lines that are in unexpected places. This forces us to create a new plan, which can cause a time delay

  • There are more surprises that can happen too! We plan things down to the last detail, but plans are never 100% perfect, 100% of the time



 We thank you for all your patience during construction to keep our workers safe!

May 15 → November 29 2024

UNDERWAY: Herder Drive Rehabilitation

Planned work for 2024:

Tasks

Complete

  • 2024 work includes Herder Drive rehabilitation from Hagerman Rd to the park trail just north of Heenan Cresent
  • Stormwater, roadway surface, and sidewalks
  • Work on stormwater lines must happen after spring breakup
  • February 14, 2024: issued a tender for the roadway construction
  • March 25: Council approved Urban Dirtworks as the Herder Drive construction contractor
  • June 11, 2024: Construction begins, and construction was completed before September depending on weather
  • August 7, 2024: The first layer of asphalt is in place and the road is fully open to all traffic


Why can't we do construction projects according to a set schedule?

  • Weather is the boss of construction. If we have bad weather, we must delay projects

  • Construction supplies sometimes arrive on time, sometimes they arrive late. For example, if concrete supplies for sidewalks are delivered late, we can't start the construction

  • Sometimes we find surprises in the ground. We make every effort to survey before breaking ground, but sometimes we find underground utilities like gas lines that are in unexpected places. This forces us to create a new plan, which can cause a time delay

  • There are more surprises that can happen too! We plan things down to the last detail, but plans are never 100% perfect, 100% of the time



 We thank you for all your patience during construction to keep our workers safe!

April 20 → November 15 2023

COMPLETE: 2023 Herder Drive Rehabilitation

Work planned for 2023 includes:

  • Mill and pave asphalt on Herder Drive, from Hinshaw Drive to Hagerman Road
  • Concrete repairs
  • Landscaping


Why can't we do construction projects according to a set schedule?

  • Weather is the boss of construction. If we have bad weather, we must delay projects

  • Construction supplies sometimes arrive on time, sometimes they arrive late. For example, if concrete supplies for sidewalks are delivered late, we can't start the construction

  • Sometimes we find surprises in the ground. We make every effort to survey before breaking ground, but sometimes we find underground utilities like gas lines that are in unexpected places. This forces us to create a new plan, which can cause a time delay

  • There are more surprises that can happen too! We plan things down to the last detail, but plans are never 100% perfect, 100% of the time



 We thank you for all your patience during construction to keep our workers safe!

April 01 → November 30 2022

COMPLETE: Herder Drive Rehabilitation

Work completed in 2022 includes:

  • Removal and installation of storm main
  • Rehabilitation of Herder Drive and Hinshaw Drive intersection
  • Rehabilitation of Herder Drive from Hinshaw Drive to Hagerman Road
April 01 → November 30 2021

COMPLETE: Road and storm water work

Work completed in 2021 included:

  • Rehabilitation of Hunter Road
  • Rehabilitation of Hinshaw Drive from Hunter Road to Herder Drive
  • Rehabilitation of the Hewlett Park storm pond
  • Rehabilitation of the drainage channel from Hagerman Road to Erickson Drive
April 01 → November 30 2020

COMPLETE: Drainage channel and road work

Work completed in 2020 included:

  • Construction of drainage channel from Erickson Drive to Hagerman Road
  • Rehabilitation of Hunter Road
  • Rehabilitation of Hinshaw Drive from Hunter Road to Herder Drive
  • Rehabilitation of the Hewlett Park storm pond
April 01 → November 29 2019

COMPLETE: Storm water lift station

Work completed in 2019 included:

  • Construction of the 50 Avenue storm water lift station


April 02 → November 30 2018

COMPLETE: Planning and Design

Planning and design work completed in 2018 included:

  • Creation of the Town’s first Storm water Master Plan
  • Designing the drainage routing of storm water through Hewlett Park and Hampton Pointe to the 50 Avenue storm water lift station
April 01 → November 30 2016

COMPLETE: Design and Investigate

Preliminary investigative work completed in 2016 includes:

  • Design for the 50 Avenue storm water system and storm water lift station
  • This lift station services 50 Avenue from 33 Street to 50 Street, Hampton Pointe, and Hewlett Park
  • Investigate ground conditions in the Hewlett Park and Hampton Pointe area
