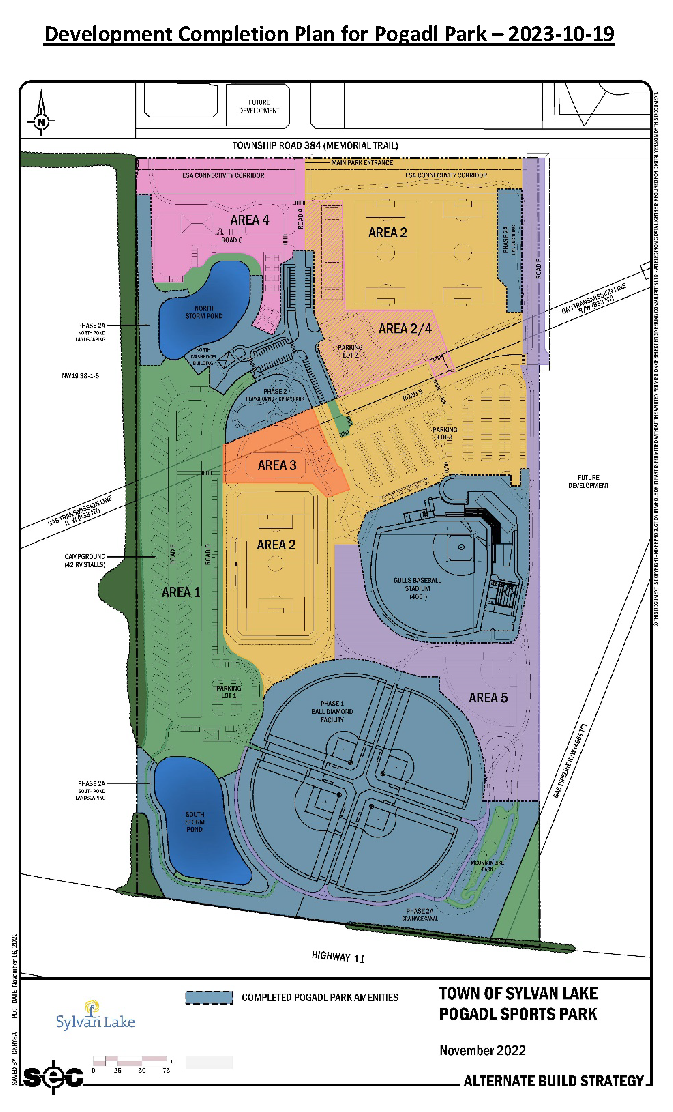

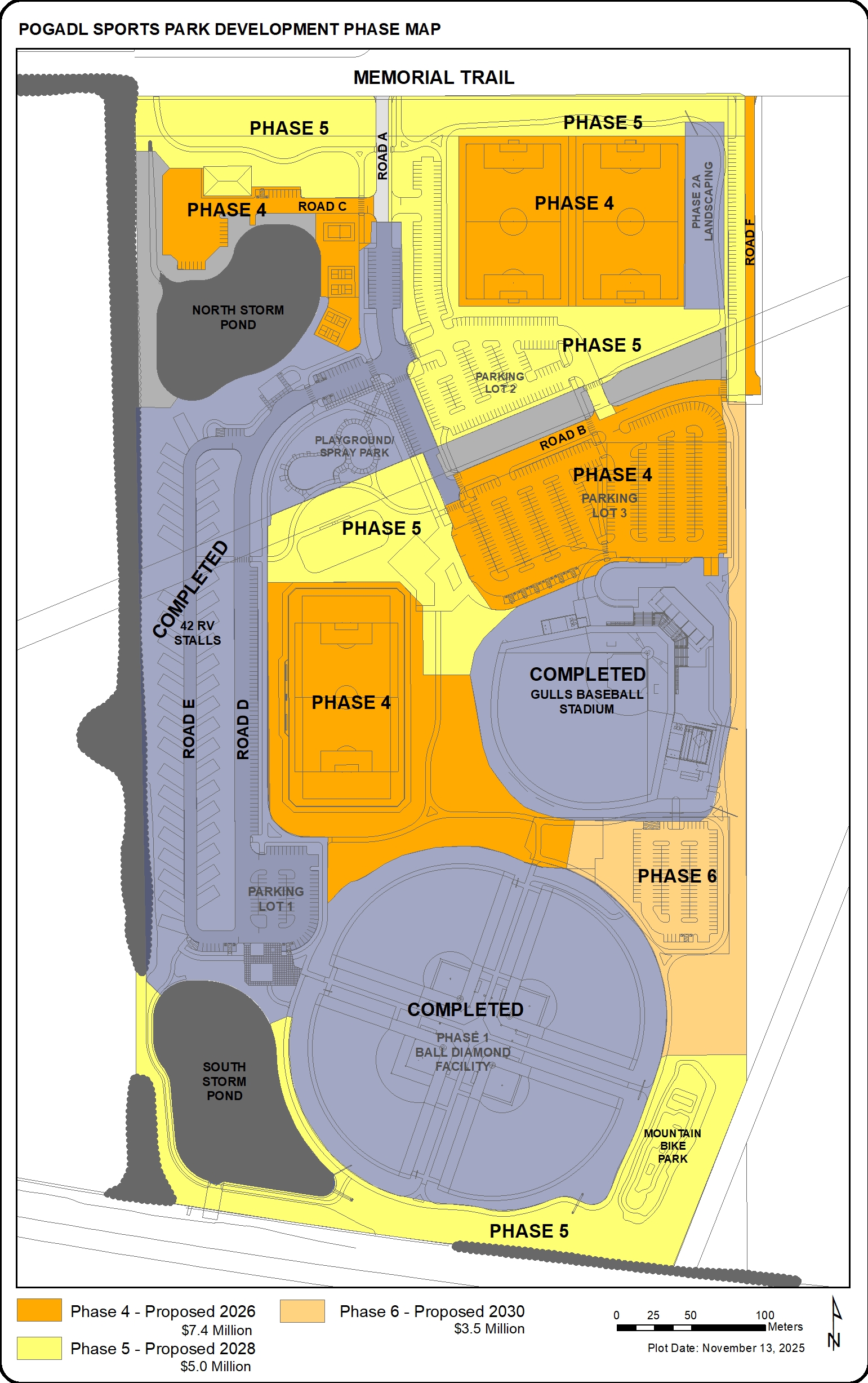

Project Phases
April 01 2026 → November 12 2031
ESTIMATED: Future Phases
2026 - Area 2 (Yellow)
- Budget: $8,000,000
- Synthetic Turf Field
- 4 Pickleball Courts
- Roads B & C
- Parking Lot 3
- Soccer Fields x 2 (grass)
- Irrigation
- Operations Yard
2028 - Area 3 (Orange)
- Budget: $4,000,000 Unfunded (Funds are not secured yet)
- Amenities Building
- Outdoor Rink
- Outdoor Leisure Ice
- Trail Development
2030 - Area 4 (Pink)
- Budget: $3,200,000 Unfunded (Funds are not secured yet)
- Tennis Courts
- Trails & Landscaping
- Operations building
- Parking Lot 2
- Road F
2031 - Area 5 (Purple)
- Budget: $1,300,000 Unfunded (Funds are not secured yet)
- Trails & Landscaping
- Parking Lot OR Little League Diamond
April 01 2025 → January 31 2026
UNDERWAY: Phase 4 Design and Engineering
Design and Engineering for phase 4 includes:
- Multipurpose field, 4 Pickleball courts, 2 natural grass soccer fields, irrigation, soft landscaping, Road B, Road C, Parking Lot 3, Operations yard, road and parking lot streetlighting
- Phase 4 construction is planned for 2026 contingent on budget approval, municipal partner funding, and grant funding
April 01 2024 → June 30 2025
UNDERWAY: Phase 3
Work planned for 2025 includes:
- Second lift of asphalt and road markings
Work planned for 2024 includes:
- Irrigation: In progress
- Detailed Design
Installation of Water, Storm, and Sanitary Lines
Opening campground and tournament house
RV Campground Construction and campground opening
- Campground Loop Paving
- RV Pads and Campground Landscaping
- Tournament House Construction
- Roads, parking lot, and trails
- Landscaping
- Electrical Primary
- Electrical Secondary
- Tournament house and RV campground opened July 2024
February 01 2021 → December 14 2022
COMPLETE: Phase 2
Tasks completed 2021 - 2022 include:
- Detailed design
- Play zone: spray park, playground, trails, and sidewalks
- Washroom facility
- Site landscaping
- Main road and designated parking areas paving
- Underground utilities (water, sanitary, storm and shallow utilities)
